Ask Michael + new Data Deck!
Twice the approvals, half the demand: Why southeast Queensland’s housing pipeline is structurally misaligned
Following the 10th March Missive, one of my paid subscribers sent through an Ask Michael question asking for a more granular breakdown of Southeast Queensland’s new housing pipeline. This is exactly the type of data-led deep dive the paid Q+A format is designed for moving beyond commentary and into the numbers.
I’ve made this one available to all subscribers so you can see the level of detail that sits behind the paid tier and why it exists.
This is a new layer to the Matusik Missive. Yes, it’s a paid offering - but it’s designed to give you more, not to plead for a donation. Subscribers can ask questions directly, which I bundle and answer several times each month in paid-only posts. My aim is to explain what’s going on, not what you want to hear. If that appeals, come on in and let’s get the Q&A started.
Now back to my answer

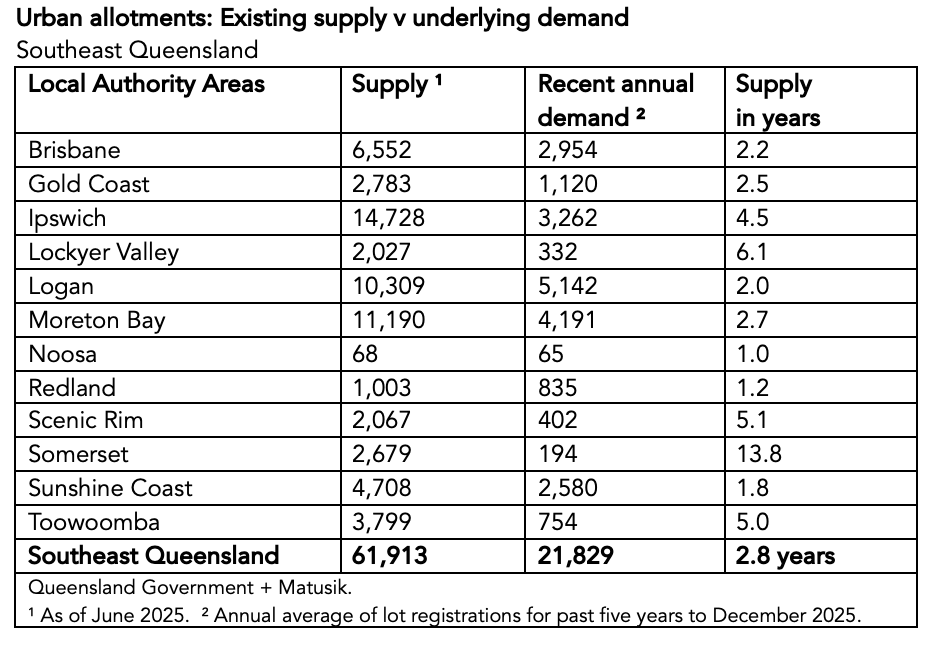

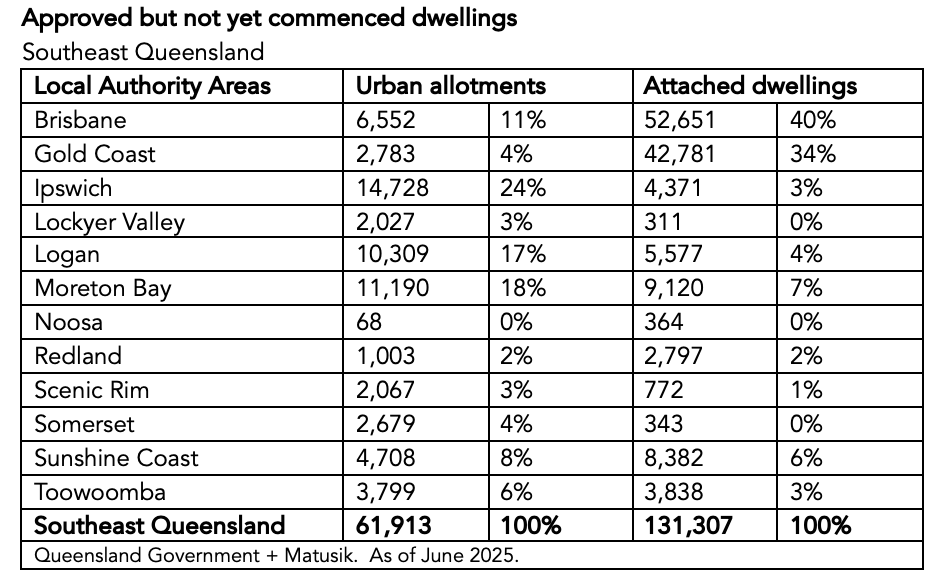

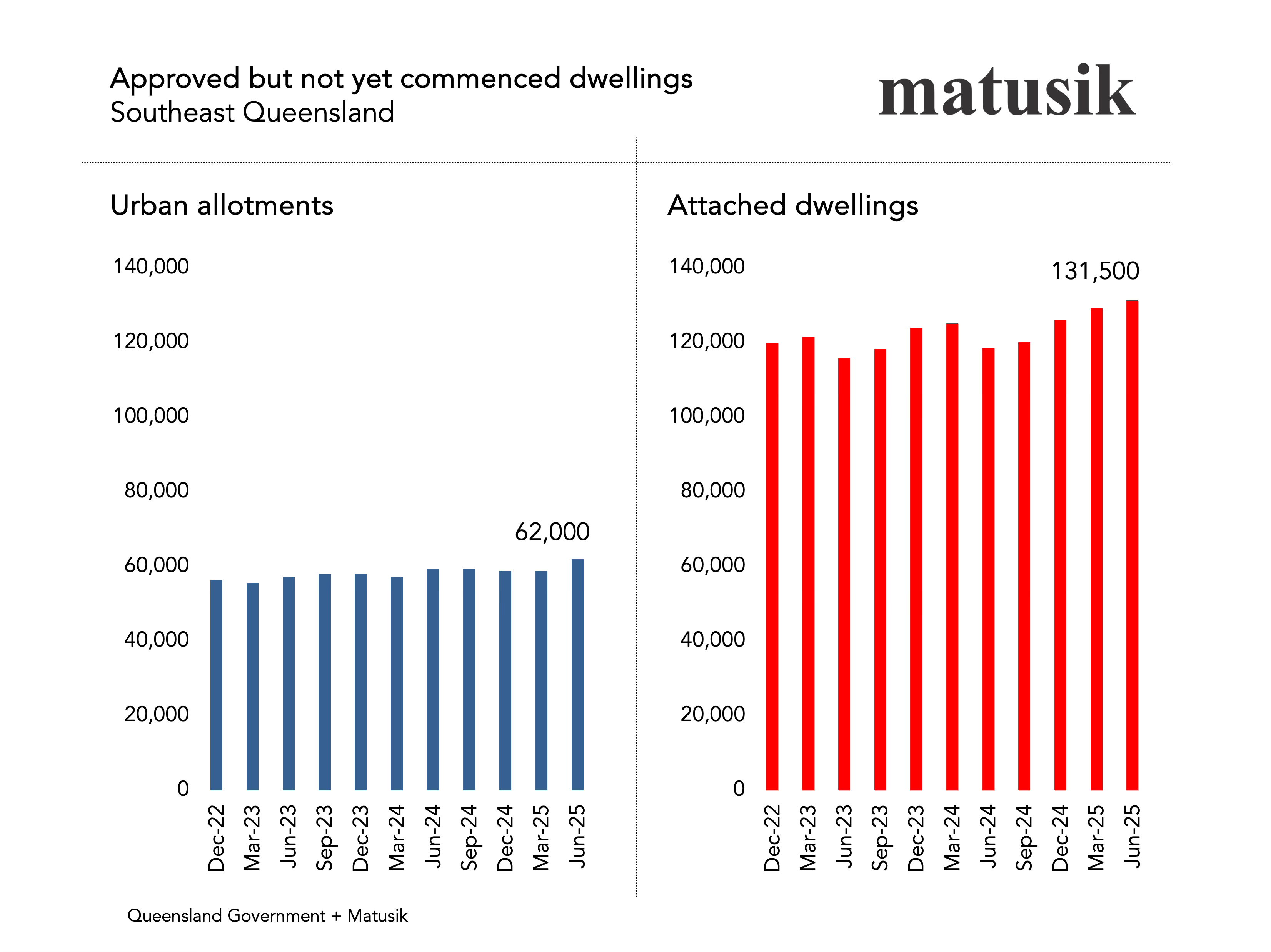

As at June 2025 there are 61,913 approved but not yet commenced urban allotments across Southeast Queensland, compared with 131,307 approved attached dwellings. In simple terms, there is more than twice as much approved stock sitting in the attached sector.
Now consider demand

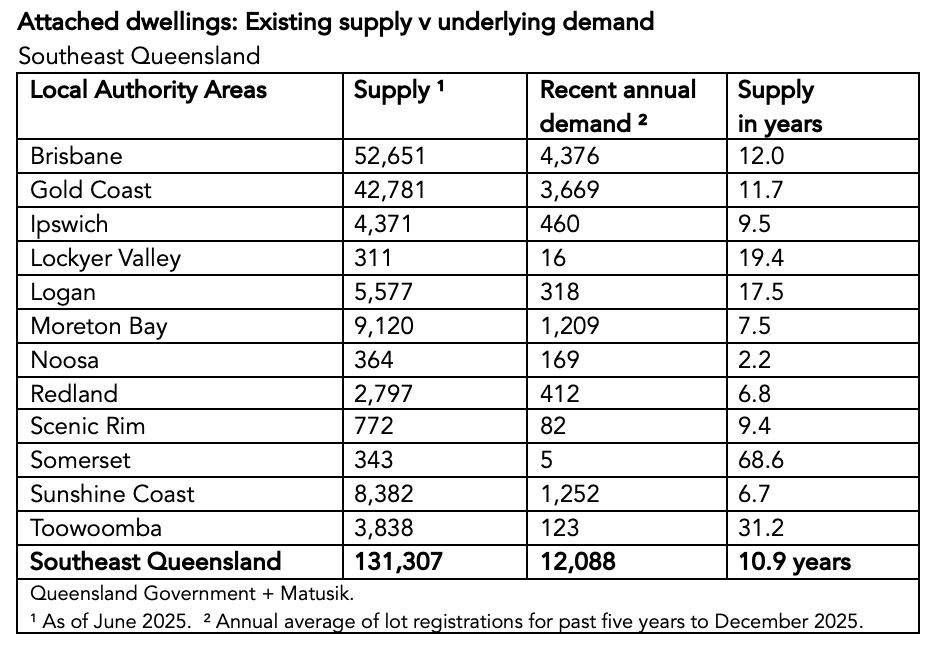

Detached housing is currently absorbing around 21,829 lots per annum across the region, which is roughly 22,000 commencements a year. That equates to just 2.8 years of supply regionally based on the 62,000 potential supply count.
Attached product is running at about 12,088 dwellings per annum in underlying demand, leaving 10.9 years of approved supply sitting in the system.
The mismatch is obvious
Brisbane and the Gold Coast alone account for close to three quarters of attached approvals, with more than a decade of supply at current absorption rates. Meanwhile, detached supply is tightest in Brisbane, Logan, the Sunshine Coast and Redland, generally sitting under three years.
If we are serious about aligning supply with demand, two things stand out.
First, something needs to unlock the attached backlog. That could be feasibility settings, funding constraints, infrastructure timing or staging. Whatever the handbrake is, it needs attention.
Second, we need to be more deliberate about accelerating detached commencements west of Brisbane, particularly in Ipswich, Lockyer Valley, Somerset and the Scenic Rim, where land exists and supply buffers are more workable.
Approvals are not the issue. Conversion is.
Revisit
I use charts every week to understand where housing markets are really heading. Paid subscribers will now receive my current Data Deck each quarter.
And to repeat paid subs can Ask Michael questions directly, and also get 20% off Ready Reckoner Reports and Master Class sessions. The May 2026 Master Class sold out - mostly to paid subs - in under a week. So thanks to all that are coming along!
